Sl No
|
Items
|
Issuing Authority
|
Status
|
|
01
|
Airport Authority Clearance
|
Airport Authority of India
|
Completed on 04/03/2008
|
|
02
|
Defence Clearance
|
Ministry of Defence
|
Completed on 25/05/2009
|
|
03
|
Environment Clearance
|
Ministry of Environment and Forest
|
Completed on 09/04/2009
|
|
04
|
Letter of Assurance( LOA) for Coal Linkage
|
Mahanadi Coal Fields Limited, Sambalpur.
|
Completed on 11/6/2009
|
|
05
|
Rail Transport Clearance
|
East Coast Railways, Bhubaneswar.
|
Completed on 17/08/2009
|
|
06
|
Power Purchase Agreement
|
-
|
Signed with PTC on 06.05.09
|
|
07
|
BTG Contract
|
-
|
Awarded to DEC, China on 16.10.08
|
|
08
|
BOP Contract
|
-
|
Awarded to NEC Consortium on March 2010
|
|
09
|
Financial Closure
|
-
|
Under Progress and expected by the end of April 2010
|
|
10
|
Site Infrastructure Works
|
|
|
Construction Power Supply
|
11 KV Distribution work under progress
|
|
|

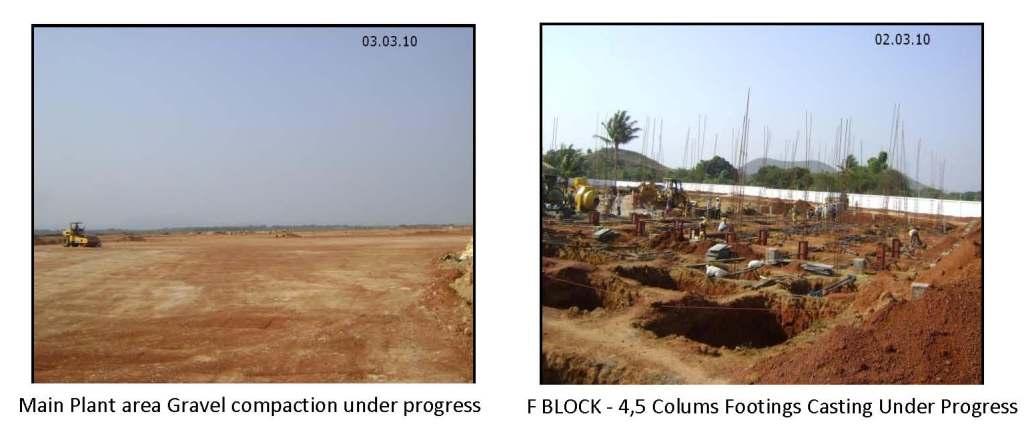

Gravel Filing
|
Power Block-Compaction under Progress
Non EPC area- Compaction under Progress
|
|
|
Water Reservoir
|
Construction Water Reservoir - water filling completed, fencing pole erection under progress
|
|
|
Diversion Drain
|
Excavation, Filling, Leveling, Sloping & Trimming – under Progress.
|
